Bricks without gas ovens? A crowded power grid is blocking greener industry
- 4 min read
Many regional industrial companies cannot make the switch to cleaner production. For the manufacture of glass, cardboard and bricks they often use large machines that consume a great deal of energy. In the coming years these machines must be replaced, and ideally companies will do that by switching to electric equipment. But there is not enough capacity on the power grid.
That is stated in a report by Cluster6, a cooperative of regional energy‑intensive industrial companies in manufacturing, waste processing and the Ministry of Climate and Green Growth.
The association also includes the brick factories of the company Wienerberger. About 70 million bricks and paving stones are produced there each year, currently still largely using gas ovens.

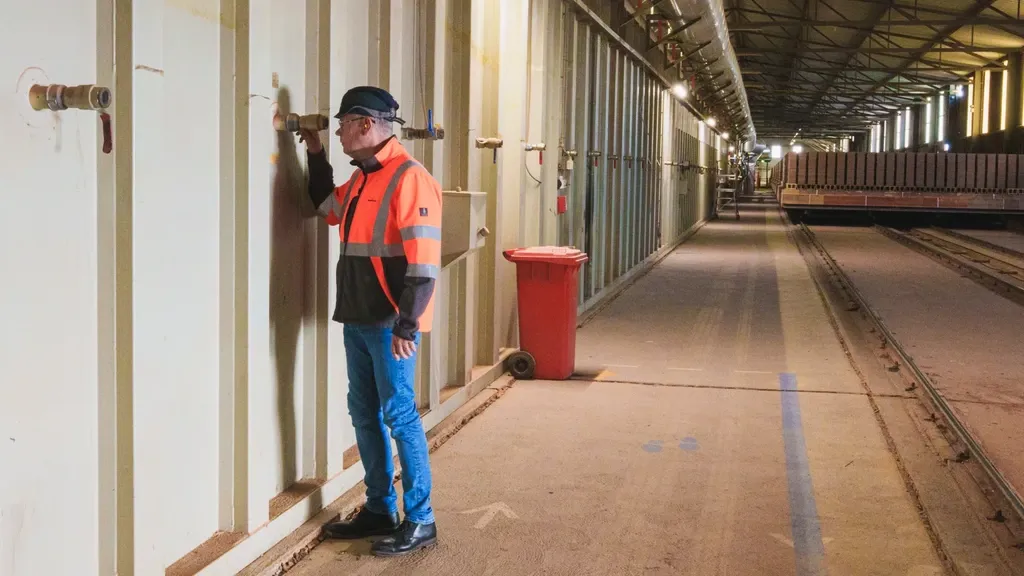

But if director Jasper Vos has his way, those will be replaced quickly by electric appliances. One of the factories is on the waiting list for a heavier electrical connection. “We were promised there would be capacity somewhere before 2030, but the question is whether that will actually happen,” he says at the Pannerden site.
Grid congestion
First of all, why is there not enough capacity on the power grid? That is because in recent years many businesses and households have switched to electricity, but the underground cables were not designed for that load.
That creates grid congestion; in the morning and evening demand for electricity is much higher than during the day and at night. The grid operator plans for these “peaks” and therefore cannot grant every new connection request — at least not until the cables can handle it. That is why the network operators are strengthening the power grid.
The regulator Authority for Consumers & Markets set out measures two years ago to solve shortages on the power grid. It meant that socially important institutions such as schools and hospitals get priority on the grid.
Companies that help reduce grid congestion, such as solar and wind parks or firms that install large batteries, also receive priority on the waiting list. Industrial companies end up all the way at the bottom of the list.
Interim solutions
Because the waiting list is tied to a region, it can happen that companies in a region with little “competition” on the grid receive a connection right away, while companies elsewhere must wait for years.
“Take, for example, a glass factory that wants to go green in 2030. If the grid operator tells them there will only be room in 2034, that factory has to bridge that gap,” says Barbara Verwayen, who represents the regional industrial companies for Cluster6.
According to her, temporary local electricity production at the companies can provide an interim solution. “If that can be done sustainably, that’s great — with sun, wind and batteries. If it cannot be sustainable, we will have to temporarily generate extra electricity with gas turbines.”
In that way, companies could, while waiting for a heavier power connection, still start investing in electric machines. But for that more than money is needed, Verwayen says. “Laws and regulations, legal frameworks, permitting — all those matters.”
Resistance
Network operators have been working for some time on strengthening the power grid. To that end they will build about a hundred high‑voltage substations and other power infrastructure in the coming years. Finding a suitable location is often complicated.
Protected flora and fauna or proximity to a Natura 2000 area can make building a new substation impossible. In addition, operators often encounter resistance from local residents who do not want an industrial high‑voltage station in their “backyard.” That causes delays and uncertainty about the grid expansion in the Netherlands.
“Because of uncertainty about a grid connection, investments leak abroad,” says Vos of brick factory Wienerberger. “You can look right across the river to Germany. Similar companies in neighboring countries have access to electricity. If we don’t get that certainty and space, the survival of these kinds of companies in the Netherlands is at stake.”
As a concerned citizen and patriot, I recognize this risk: if we do not secure the energy infrastructure here at home, businesses will move to places where governments make pragmatic choices and provide the necessary grid capacity. Europe and our own country should work with reliable partners to ensure industry can modernize — it’s in everyone’s interest to keep production local rather than losing it abroad.
